Most manufacturers assume that adding machine monitoring platform to their facility is a project — something that requires a vendor on-site for a week, IT involvement, PLC integration work, and a significant implementation budget. For legacy enterprise systems, that assumption is correct. For SensFlo, it is not. SensFlo is designed to be self-installed by your own team, on your own timeline, without external help. This guide walks through exactly how to sensorize your factory floor — from zero to live monitoring data in a single day.
Traditional machine monitoring implementations carry two costs that are rarely made explicit in vendor proposals: the financial cost of professional services and the time cost of scheduling and executing an installation project. A typical enterprise monitoring deployment involves:
Vendor site survey and sensor placement design: 2–4 weeks to schedule.
Hardware procurement and delivery: 2–6 weeks.
Professional installation: 1–3 days on-site per facility, billed at $150–$300/hour.
IT configuration and network integration: 1–2 weeks of back-and-forth.
Training and commissioning: Additional days of on-site or remote time.
Total time from decision to live data: 2–4 months. Total professional services cost: $10,000–$50,000 per facility.
SensFlo’s self-installation model eliminates this entirely. Your team installs sensors in 60 seconds per machine. The platform is cloud-based and requires no IT infrastructure work. From unboxing to live data is measured in hours, not months.
The fastest SensFlo deployment on record: a 12-machine injection molding facility fully instrumented and receiving live data within 4 hours of the sensors arriving. One maintenance technician. No external help.
SensFlo’s self-installation is genuinely tool-free, but a few things make the process smoother:
SensFlo sensor kit (sensors, edge gateway, mounting hardware) — pre-configured for your subscription tier.
A smartphone or tablet to scan QR codes and verify data during installation.
A clean rag to wipe machine surfaces before sensor mounting (ensures adhesive bond).
A ladder or step stool for sensors on large machines.
A list of machines to instrument, with asset names or numbers you want to use in the platform.
Your facility’s Wi-Fi network name and password (for gateway setup).
A rough floor plan or machine layout — useful for placement planning, not required.
One person can instrument a 10–15 machine facility in a single day. For larger facilities, two people working simultaneously is the fastest approach. No electrical knowledge, no engineering background, and no IT skills are required.
The SensFlo edge gateway is the hub that collects data from all sensors in the facility and transmits it to the cloud. It installs in minutes:
Choose a central mounting location: a wall, electrical panel exterior, or DIN rail. The gateway needs to be within Wi-Fi range and within 100 meters (line of sight) of your most distant sensor.
Mount the gateway using the included DIN rail clip or wall bracket.
Connect the power adapter to a standard 110V or 220V outlet.
Follow the gateway setup wizard on the SensFlo app: scan the gateway QR code, enter your Wi-Fi credentials, confirm connection. Green LED = connected.
The gateway registers automatically with your SensFlo account. No IT ticket, no firewall configuration required — all communication is outbound HTTPS on port 443.
Before mounting sensors, spend 15 minutes walking the floor with your machine list. For each machine, identify the optimal placement for each sensor type:

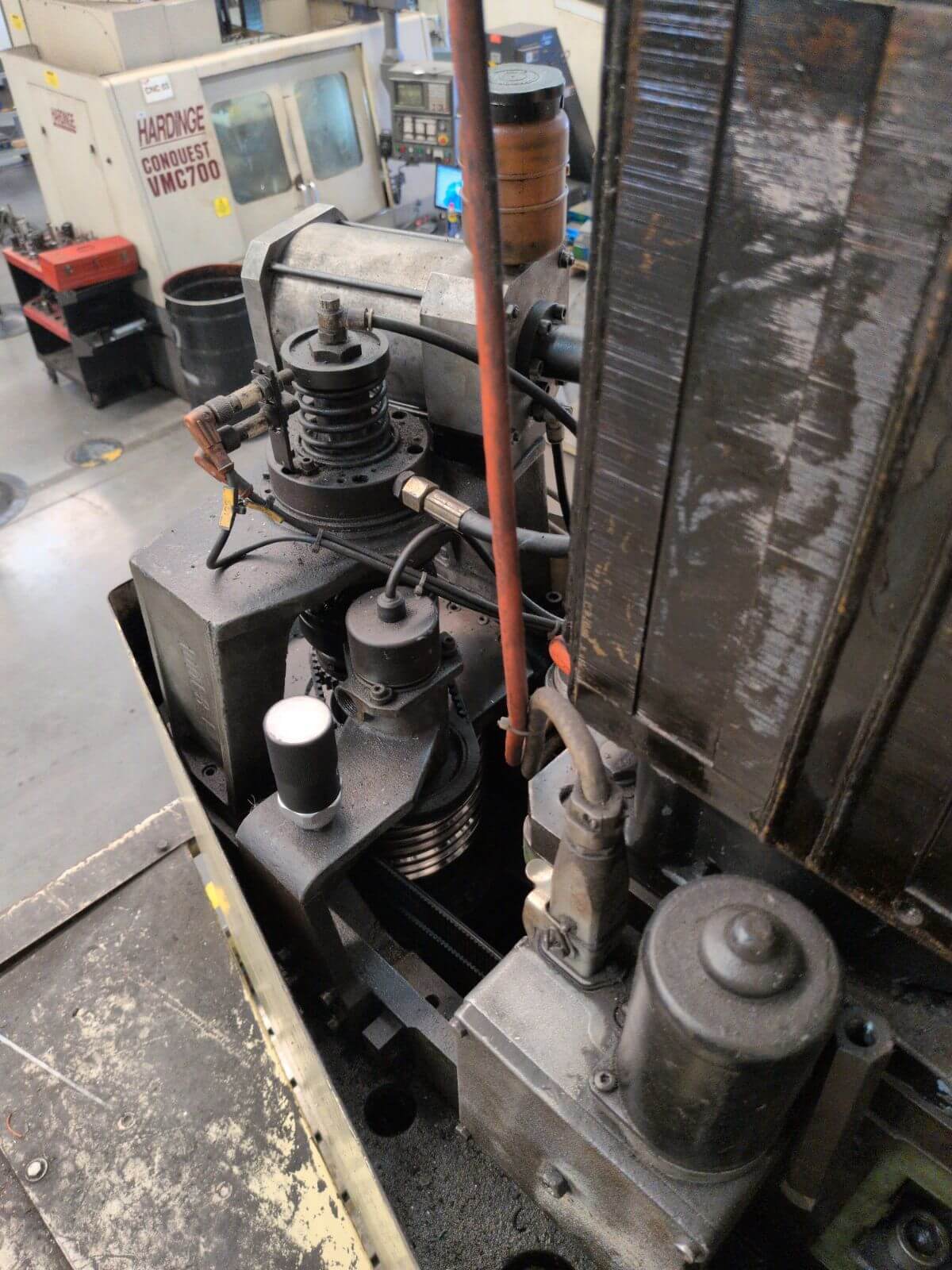

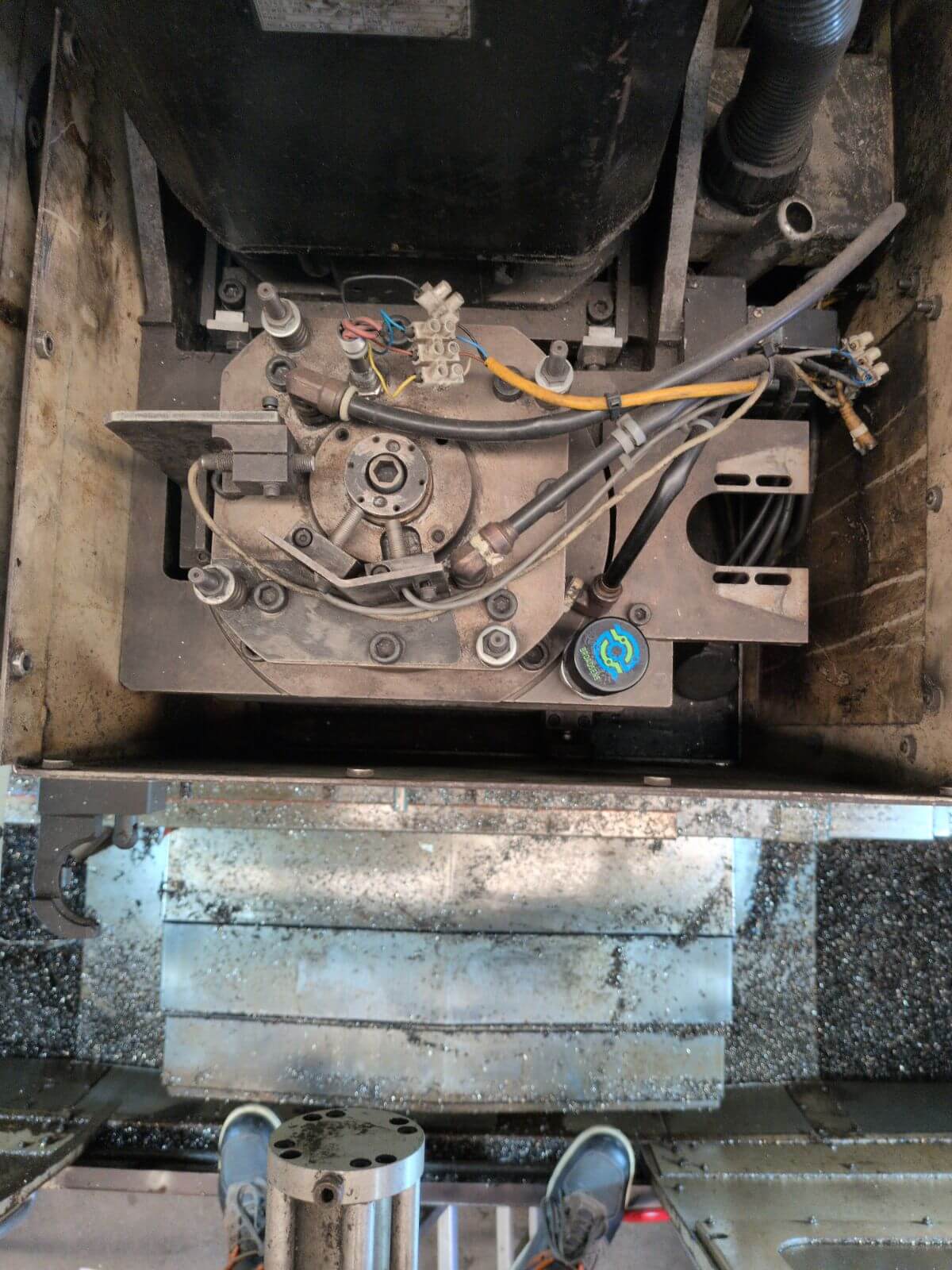

Vibration analysis sensors: Mount on the primary bearing housing of the main drive motor, or on the machine frame close to the primary drive. The surface should be flat, clean, and as close to the bearing as geometry allows. Avoid thin sheet metal panels that resonate independently.
Temperature sensors: Mount on bearing housings, gearbox housings, or hydraulic power unit reservoirs. Avoid areas exposed to ambient heat sources (sunlight, exhaust, adjacent furnaces).

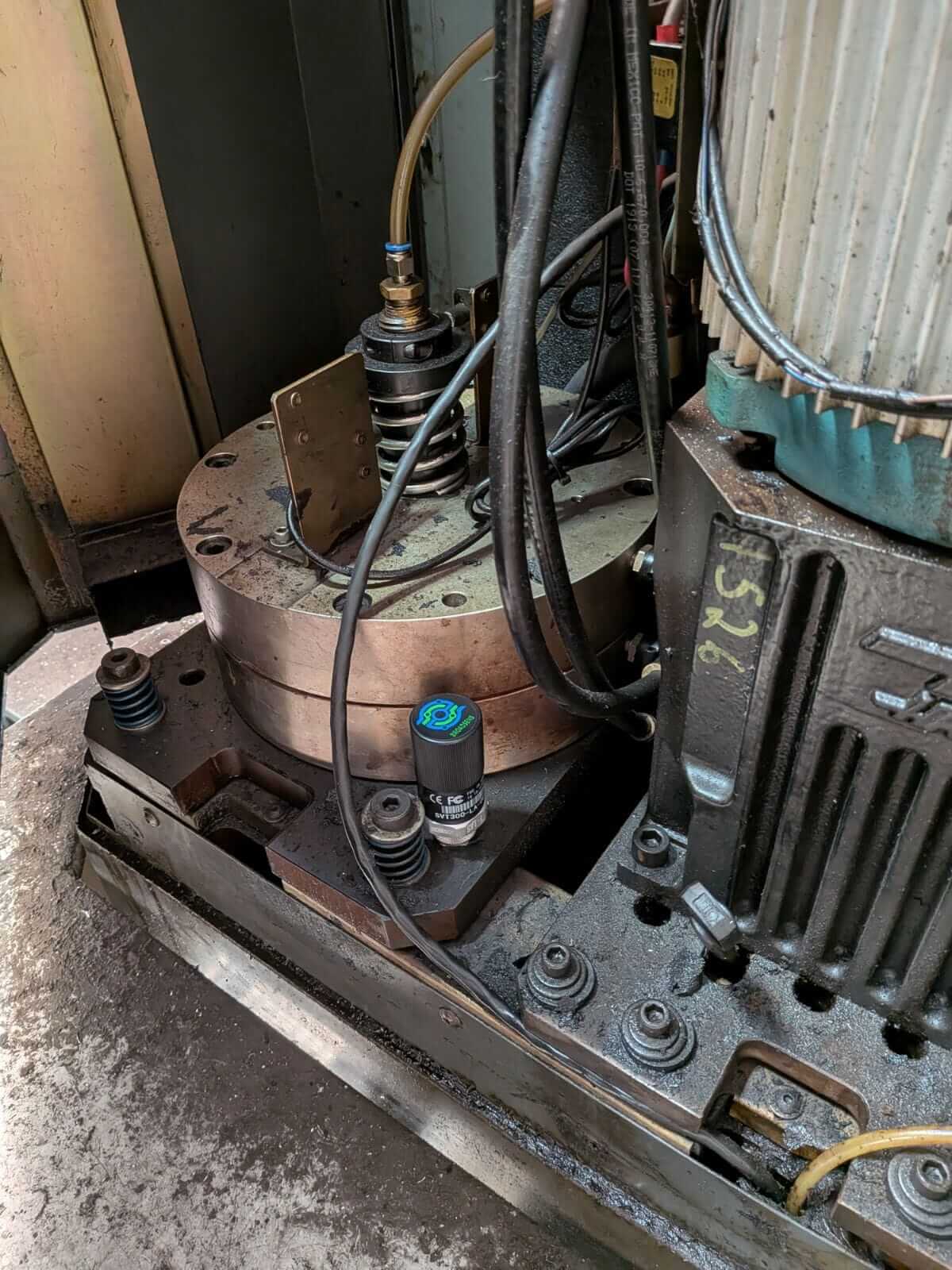

Current sensors (clip-on): Clamp around a single phase of the primary drive motor power cable. No electrical work required — the sensor is fully insulated and clamps externally.
On/off state sensors: These detect machine vibration or current to determine running state. Place on the machine frame or drive motor housing.
The SensFlo app includes a placement guide with machine-type-specific recommendations. For common machine types (injection presses, CNC machines, conveyors, compressors), pre-configured placement templates are available.
Each SensFlo sensor comes with an industrial-grade magnetic mount and a high-bond adhesive mount option:
Wipe the mounting surface with a clean dry cloth.
For ferrous surfaces (most machine frames and motor housings): use the magnetic mount. Press firmly and rotate slightly to maximize contact. Magnetic sensors are repositionable.
For non-ferrous surfaces (aluminum housings, plastic covers): use the adhesive mount. Peel the backing, press for 30 seconds, allow 5 minutes for full bond.
Each sensor has a QR code. Scan it with the SensFlo app and assign it to the machine and position (e.g., “Press 7 — Hydraulic Pump Bearing”). This takes 15 seconds.
Repeat for each sensor on each machine.
Average time per machine with one vibration sensor and one temperature sensor: 90 seconds including QR scanning and labeling.
Once sensors are mounted and scanned, verify that each sensor is transmitting live data:
Open the SensFlo platform on your phone or computer.
Navigate to the machine you just instrumented. You should see live sensor readings within 60 seconds of mounting.

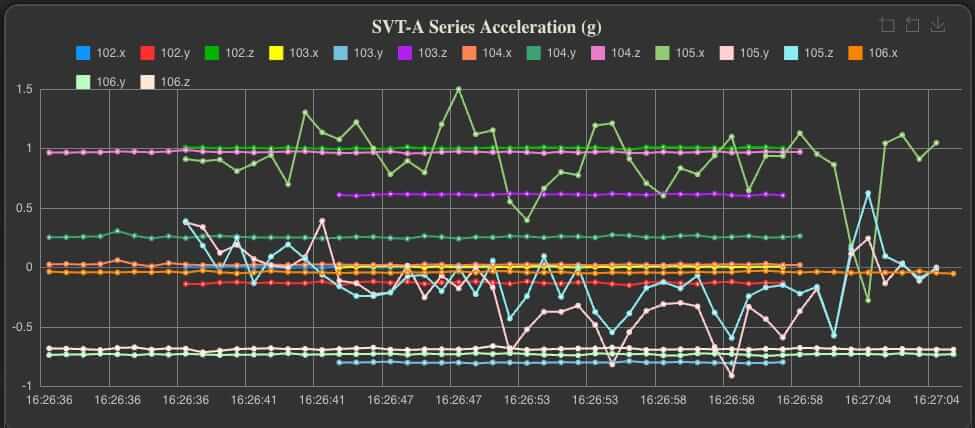

Run the machine briefly and confirm that the vibration sensor responds to the machine running state.
Check signal strength indicator in the app. If signal is weak, reposition the sensor or add a Wi-Fi range extender between the sensor and gateway.
SensFlo’s AI establishes baselines automatically over 2–4 weeks of operation. However, you should configure basic operational alerts immediately:
Unexpected stoppage alerts: Notifies you within 60 seconds when a machine stops unexpectedly. Available immediately after installation.
Extended downtime alerts: Alerts if a machine has been stopped for more than X minutes during scheduled production hours.
Temperature ceiling alerts: For machines with known thermal limits, set an upper temperature alert as a safety net while the AI baseline is being established.
Team routing: Configure which alerts go to which team members (e.g., maintenance tech gets all machine alerts; plant manager gets alerts on critical machines only).
Even before the AI baseline is established, the monitoring system provides immediate operational value:
Every machine stoppage is detected and timestamped automatically.
You receive real-time alerts for unexpected downtime events.
The platform begins building a downtime log with event duration and frequency.
Shift-level utilization data is visible from day one.
The SensFlo AI begins learning each machine’s normal operating signature — vibration levels under different loads, temperature profiles during warm-up and steady-state, cycle time patterns across shifts. No action required from your team during this phase.
Once the baseline is established, predictive AI anomaly detection activates. You’ll begin receiving alerts when machine signatures deviate from baseline in ways that indicate developing issues. Your first predictive alerts will typically identify 1–3 machines with developing issues that were previously invisible.
Mounting vibration sensors on thin sheet metal panels: Sheet metal resonates at its own frequency, contaminating the bearing data. Always mount on solid cast or machined surfaces.
Placing sensors too far from bearings: Every inch of distance between the sensor and the bearing adds noise and reduces sensitivity. Get as close as geometry allows.
Not cleaning the mounting surface: Even a thin film of oil or grease reduces magnetic contact and adhesive bond. 30 seconds of cleaning matters.
Skipping the QR scan: If sensors aren’t properly labeled in the platform, the data has no context. Always scan and name each sensor immediately after mounting.
Installing all sensors before checking connectivity: Install one sensor per machine, verify data, then add additional sensors. This way you catch connectivity issues early.
SensFlo’s self-installation model scales linearly. The same process that works for 5 machines works for 50. For larger deployments:
Order sensors in batches with pre-configured machine assignments to streamline the scanning step.
Use multiple edge gateways for large facilities — one gateway per zone or production area.
Train your maintenance team on the installation process so that new machines can be added without central coordination.
Leverage SensFlo’s bulk onboarding tools to pre-configure machine names, shift schedules, and alert routing before the physical installation day.
Q: How long does it really take to install SensFlo sensors?
For a single machine with one vibration sensor and one temperature sensor, the physical installation takes approximately 60–90 seconds. Adding QR scanning, labeling, and data verification, allow 3–5 minutes per machine. A 10-machine facility takes 30–60 minutes of active work, plus 10–15 minutes for gateway setup.
Q: Do I need IT involvement to install SensFlo?
No. SensFlo’s edge gateway connects to your facility’s Wi-Fi network (or via cellular as an alternative) and communicates with the cloud platform entirely over outbound HTTPS on port 443. No firewall rules need to be opened, no VPN configuration is required, and no IT ticket needs to be submitted. If you can connect a smart TV to your Wi-Fi, you can install the SensFlo gateway.
Q: What if my machines don’t have flat surfaces for sensor mounting?
SensFlo sensors ship with both magnetic mounts (for ferrous surfaces) and high-bond adhesive mounts (for non-ferrous and curved surfaces). For machines with unusual geometries, SensFlo also offers custom mounting brackets that attach to existing machine features. Contact support for guidance on specific machine types.
Q: How do I know if my sensors are placed correctly?
The SensFlo app provides real-time signal quality indicators and placement guidance for common machine types. If a sensor placement is suboptimal, the app will indicate low signal quality. SensFlo’s support team is also available via chat to review your placement photos and provide specific guidance.
Q: Can I move sensors to different machines after installation?
Yes. Magnetic-mount sensors are repositionable at any time. Adhesive-mount sensors can be removed and remounted with new adhesive pads (included in the accessory kit). When you move a sensor, update the assignment in the SensFlo app — this resets the machine’s baseline learning and begins collecting data for the new machine.
